What a cyclone-prone monsoon teaches you about on-site precast production
There is a set of photos from Dhamra that I keep coming back to. None of them show a finished pavement. They show our production area under brown water. I am putting them here because they say more about how we work than any finished pavement could.

In 2021 we were at Dhamra Port on the Odisha coast, making and laying 2,50,000 square metres of 80 mm M-50 unipavers for Adani Ports: internal roads, truck parking and a steel stackyard. It is a very remote location. It also sits on a stretch of coast with extreme monsoons and frequent cyclones.
Those two facts together are what made the job. Remote means help is far away. Cyclone-prone means you will need help.



What weather does to a site plant
A factory in an industrial estate has drains, a boundary wall and a roof that has survived twenty monsoons. A plant at a project site has whatever you built in the weeks before production started. When heavy rain comes, it finds every weakness at once.

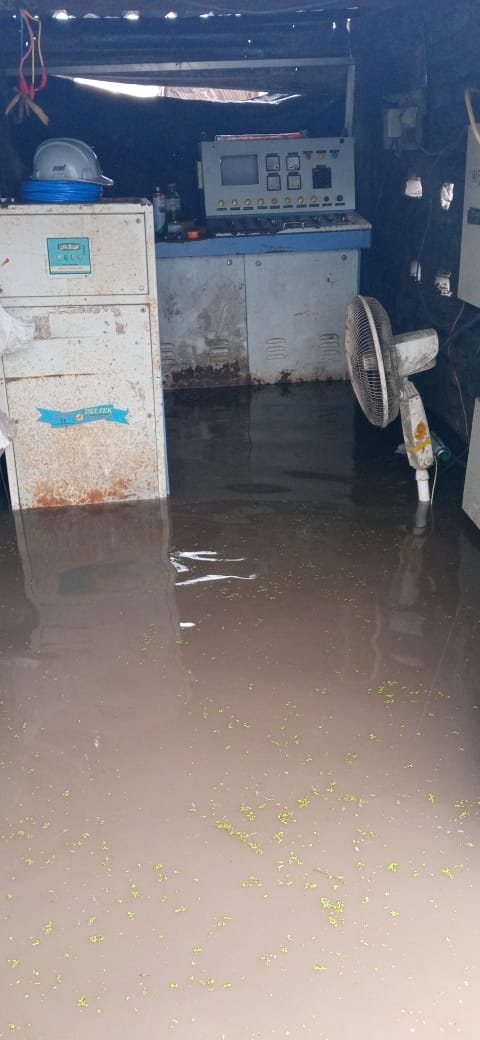

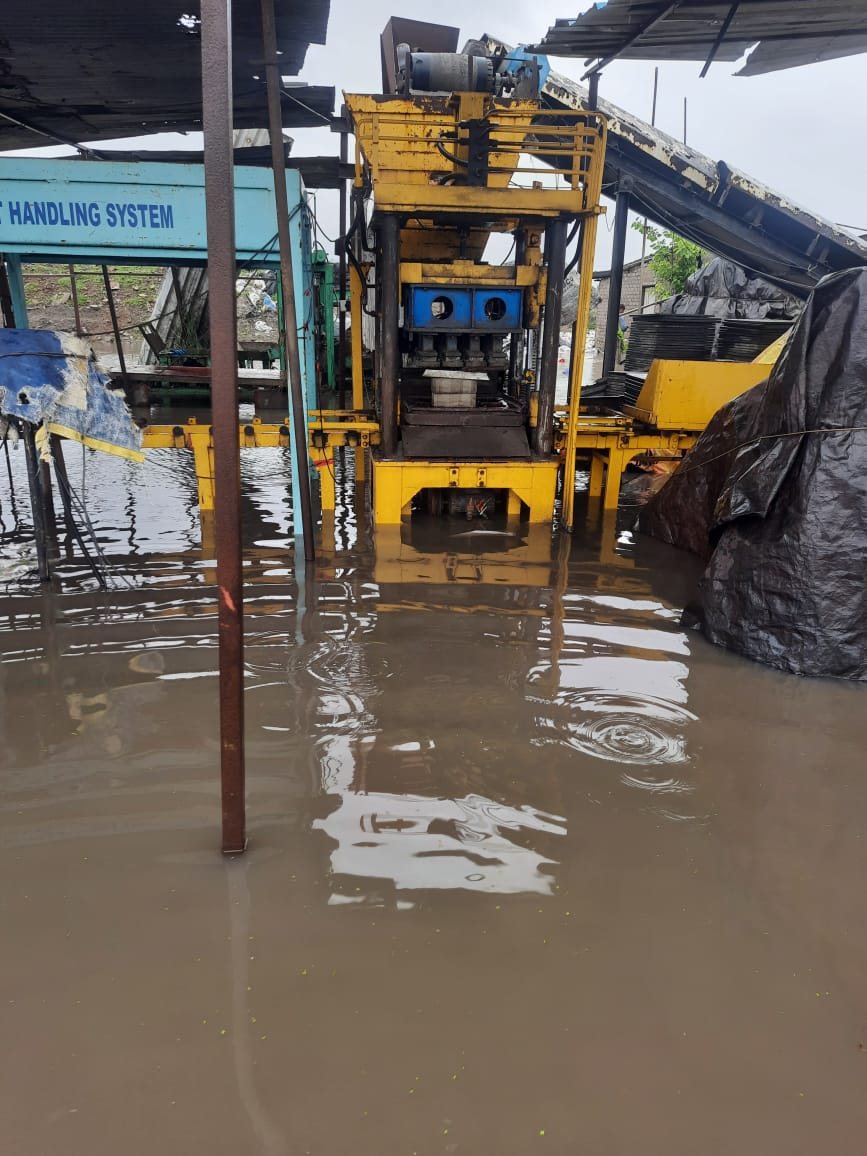

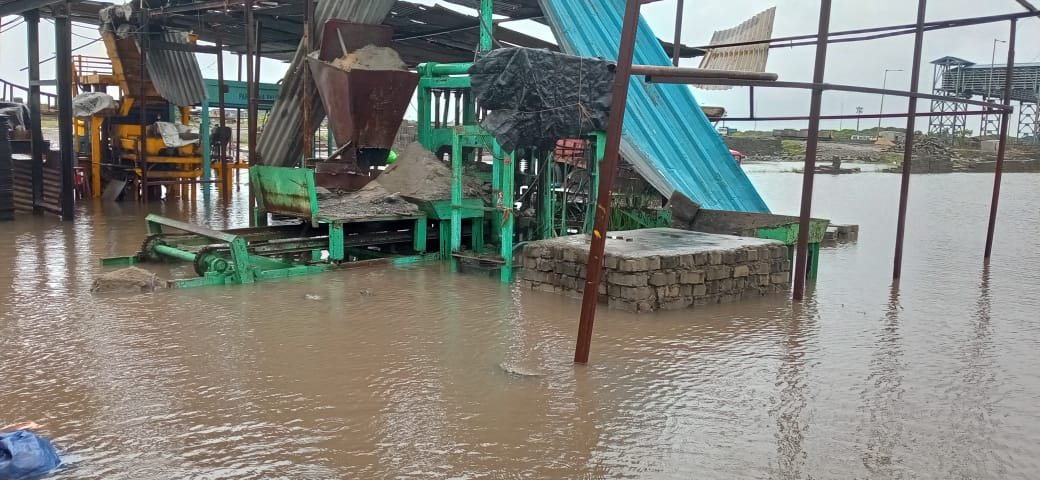

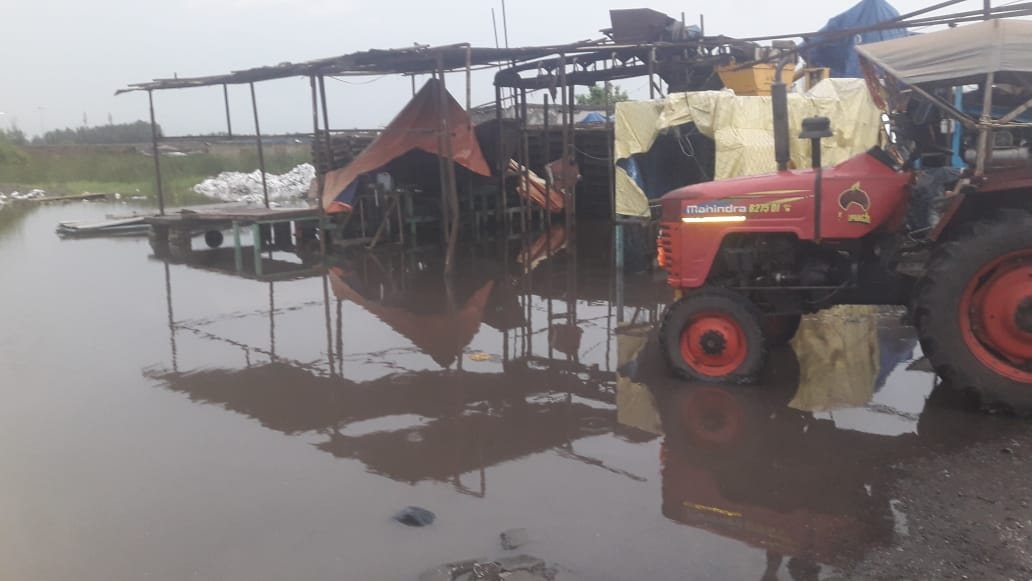

Water gets into the production area. Cement that gets wet is lost. Fresh blocks in the curing area and stacks in the yard sit in water. Access roads turn to slush, so trucks with raw material cannot reach you, and trucks carrying finished blocks to the work front cannot leave. And the electrical side, the panels, motors and cables, is where water does the most damage.
What resilience actually means on a job like this
Plan as if the water will come. On a coastal site in the monsoon, flooding is not an if. Cement storage, electrical panels and the things that cannot get wet need to be placed and protected with that in mind from the first day.
Build a buffer before the weather does. Cured, tested stock in hand is what keeps the job alive through a bad week. If production stops for a few days, the laying can still continue wherever the ground allows, and the programme does not collapse.
Cover what you can. Tarpaulins, raised platforms, sealed bags. None of it is sophisticated. All of it matters.
Do not restart in a hurry. The temptation when the water goes down is to switch everything back on and make up for lost time. That is how you burn out a motor or produce a batch of bad blocks. Machines get cleaned, electricals get checked, moulds get inspected, and the first blocks after a restart get tested before full production resumes.
Keep the same people. On a remote site nobody is coming from the city to fix things. It is the operators and supervisors who are already there who get the plant running again. We have worked with the same core team for many years, and jobs like Dhamra are where that shows.


Why I am showing you this
Every contractor's website shows finished work in good light. Finished work tells you what someone can do when things go to plan. What you really want to know before you hand over a large, remote job is what they do when things do not.
At Dhamra, the answer was that the pavement got made and laid: roads, truck parking and the steel stackyard, 2,50,000 square metres of it. The weather was a condition of the job, not an excuse. If your project is somewhere difficult, send us the location and BOQ. We will tell you honestly what it will take.
